WASHINGTON — While the first quarter of the 2026 fiscal year produced record results on several fronts, equipment constraints and major capital projects are likely to make the second quarter a challenge, Amtrak’s board of directors was told during its meeting today (Wednesday, Jan. 28).
Ongoing issues with the delivery of NextGen Acelas also continue to impact the company on a number of fronts, the board was told during the publicly streamed portion of the meeting.
Chief Financial Officer Costin Corneanu told the board first-quarter ridership was up 422,000 over the same period a year earlier, a 4.7% increase and 49,000 riders ahead of the company’s plan. Those gains came across all three service lines, with the Northeast Corridor showing a gain of 294,000, or 7.6%; state-supported service up by 95,000, or 2.4%, and long-distance up by 33,000, or 2.8%.
Operating results, however, showed a loss of $74.6 million, compared to $68 million in the first quarter of fiscal 2025. Corneanu said the Northeast Corridor remains “operationally profitable,” showing an increase of $13.7 million compared to the same period a year earlier.
Losses for state-supported operations increased by $14.2 million, or 26.4%. Decreased capacity, reflecting the loss of the Horizon car fleet, was a factor, as were higher expenses. Even with the decreased fleet, ticket revenue increased by 0.8%.
Long-distance results saw an improvement of $14.3 million year-over-year, or 9.9%. A combination of a slight increase in capacity and per-ticket yield led to a 17.4% gain in revenue.
“There is a combination of two factors here,” Corneanu said, responding to a question from board member Ellen Clegg. “One is clearly a strong revenue performance, especially on the sleeper; we actually have a good demand on the coach side, too, on the long-distance network, and that has driven the majority of the revenue and ridership improvement from a year-over-year base perspective.
“In addition to that, we’ve also been very focused on capacity in an effective way. So we can see the unit’s cost increases have been very well managed as we have grown capacity.”
Added Chief Commercial Officer Eliot Hamlisch, “a direct answer to your question is more riders traveling further paying more. So all three of those stats are up for [long-distance].”
Hamlisch cautioned that challenges will make it difficult to maintain the first-quarter results.
“Equipment delays and major infrastructure outages will continue to put downward pressure on the business throughout the rest of the year,” he said, “and we remain very steadfastly focused on mitigating those to the greatest extent possible.”
Acela update
While Hamlisch said the Northeast Corridor “continues to outperform the rest of the network,” he noted that came despite limited fleet availability. Delays in the rollout of the NextGen Acela fleet are constraining capacity and the ability to meet demand, as are the reliability issues for the legacy Acela fleet. Those trainsets, which began entering service in 2000, are now well past their projected retirement date, but are expected to be retired by year’s end.
In discussing customer satisfaction data, Hamlisch said the NextGen equipment “has brought significant enhancements to the onboard customer experience, such as better WiFi connectivity, grab-and-go café food service, and newer, cleaner train interiors. That said, customers are still acclimating to the new train layout, including wayfinding, navigation more broadly, and amenities.”
Chief Operating Officer Gery Williams said on-time performance for the Acelas was down 7% in December from the previous year.
“We now have eight NextGen trainsets in service, which represent half of the total active high-speed fleet,” Williams said, adding that the company is battling “infancy issues” with the new equipment.
“One of the major issues has been the reliability of the doors,” he said. “Alstom identified the need to recalibrate some of the door settings as the carbodies settle. Progress is being made. However, it’s been slower than we would like, and that is due to the difficulty in taking the trains out of service long enough for Alstom to do the lengthy calibration work. As we take delivery of more trainsets, the additional capacity will give us more flexibility to complete this work and other work to get us to a more steady state.”
Project outages

Along with the Acela questions, NEC operations will face disruptions from major capital projects, most notably the Penn Access project and the first phase of cutover of the new Portal North Bridge.

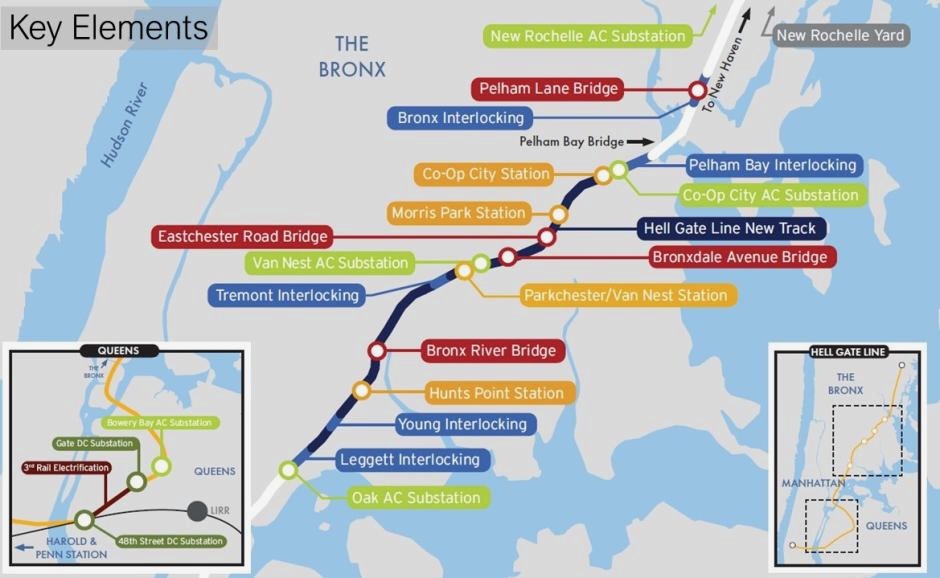

Already in progress is the Penn Access work, which involves adding capacity for Metro-North Railroad service into Penn Station via Amtrak’s Hell Gate Line. The outage that began Jan. 5 and is slated to run through March 30 involves a bridge replacement and will lead to about a 20% reduction in Amtrak service.
Laura Mason, executive vice president of capital delivery, said the project is “a double block, meaning we are going through an interlocking, taking out two blocks of track, making for a very long single track. … This is a big, big impact. Further outages will be expected roughly mid-May to mid-November. We continue to work with a contractor to minimize those outages and ensure that we are using any track time that we take as productively as possible to balance delivering this project with ensuring we can still provide service for the Northeast Corridor.”
The Portal North cutover will move operations onto one track of the two-track bridge over the Hackensack River, but will require a 50% reduction in trains between Newark and Secaucus, N.J., between Feb. 13 and March 16, Mason said. [Previous reports had the dates as Feb. 15 to March 14; see “Portal Bridge cutover …,” Trains.com, Jan. 15, 2026.]
“When we come out of that, we will have the south or westbound track operating on the new Portal North Bridge, that high, fixed bridge not needing to open for any maritime traffic,” Mason said. “… This is a very impactful outage as it takes one of our busiest sections of the corridor down to one track.”
